Project Overview
  This  project is an android game where the game master sets up the start and  destination locations on the map. Two or more individuals/teams can play the  game, each member of course has to carry around the smart phone with the GPS to  see the map and where the destination is. The game must track the paths of the  players, from the start of the game to the end, after which the paths the teams  took can be erased. As in all racing games, the goal is to get from point A to point  B, what makes this an interesting game/project, is that the teams can track  each other since the game shows where everyone is located, and they use their  phones to navigate to reach the final destination. The dots/pictures  representing each player/team should have the team's name, picture... Whoever  reaches the destination first, wins. This game is sort of like "adventure  racing", long distance. The transportation (bikes, planes, automobiles...)  options and what is allowed to use, is specified by the game master.
Reference Documents
Applicable Standards
Deliverables
| Artifact | Due Dates (Some will have multiple deliveries) |
| Meeting Minutes | Weekly |
| Individual Logs | Weekly |
| Group Project Management Reports | Weekly |
| ConOps | September 18, 2014 |
| Project Plan | September 18, 2014 |
| SRS | September 18, 2014 |
| High-Level Design | October 23, 2014 |
| Detailed Design | October 23, 2014 |
| Test Plan | November 25, 2014 |
| User's Manual | November 25, 2014 |
| Final Test Results | November 25, 2014 |
| Source, Executable, Build Instructions | November 25, 2014 |
| Project Legacy | November 25, 2014 |

Software  Life Cycle
  Incremental  Phased development will be used for the development of this project. This life  cycle will allow for the main functionality to be developed. After the main  section is implemented, additional features can be added.

Tools  and Computing Environment
  Eclipse  with Android SDK, Android, Java

Configuration  Management
  Ideas  will be presented to the group during meetings/online postings. This will be  done at the beginning of the meeting or next meeting depending on the nature of  the content.

Quality Assurance
  During the coding phase, two  people should proofread major coded segments to ensure that it is maintainable.  Each coded section should also be tested thoroughly to ensure proper  functionality. All documentation should follow the standards listed above. All  members must take part of quality assurance. Any deviations from the projected  goals should be announced to the entire team to ensure that everyone is  following the proper agenda. Results based on quality assurance will be posted  on the website.
Risk Management
Table  of Work Packages, Time Estimates, and Assignments
  Documentation will be done by  everyone in the group during meetings. Coding will be broken up into sections  to be divided amongst team members which should take up to 4 weeks.

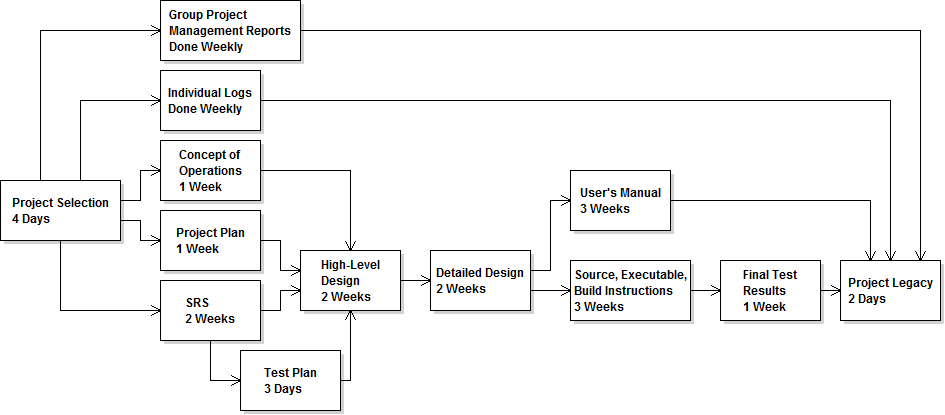

PERT Chart

Technical  Progress Metrics
  Progress will be measured by making  a list of features of what needs to be completed and using a check list  approach to measure progress. Deadlines will be added to scale with the number  of features expected to be delivered to the client by a certain date.

Plan  for tracking, control, and reporting of progress
  Data collection will include  features that are being worked on or completed (who is working on what feature,  time invested in the feature, and issues that may come up). Progress on goals  established by the group will be presented in group meetings.
